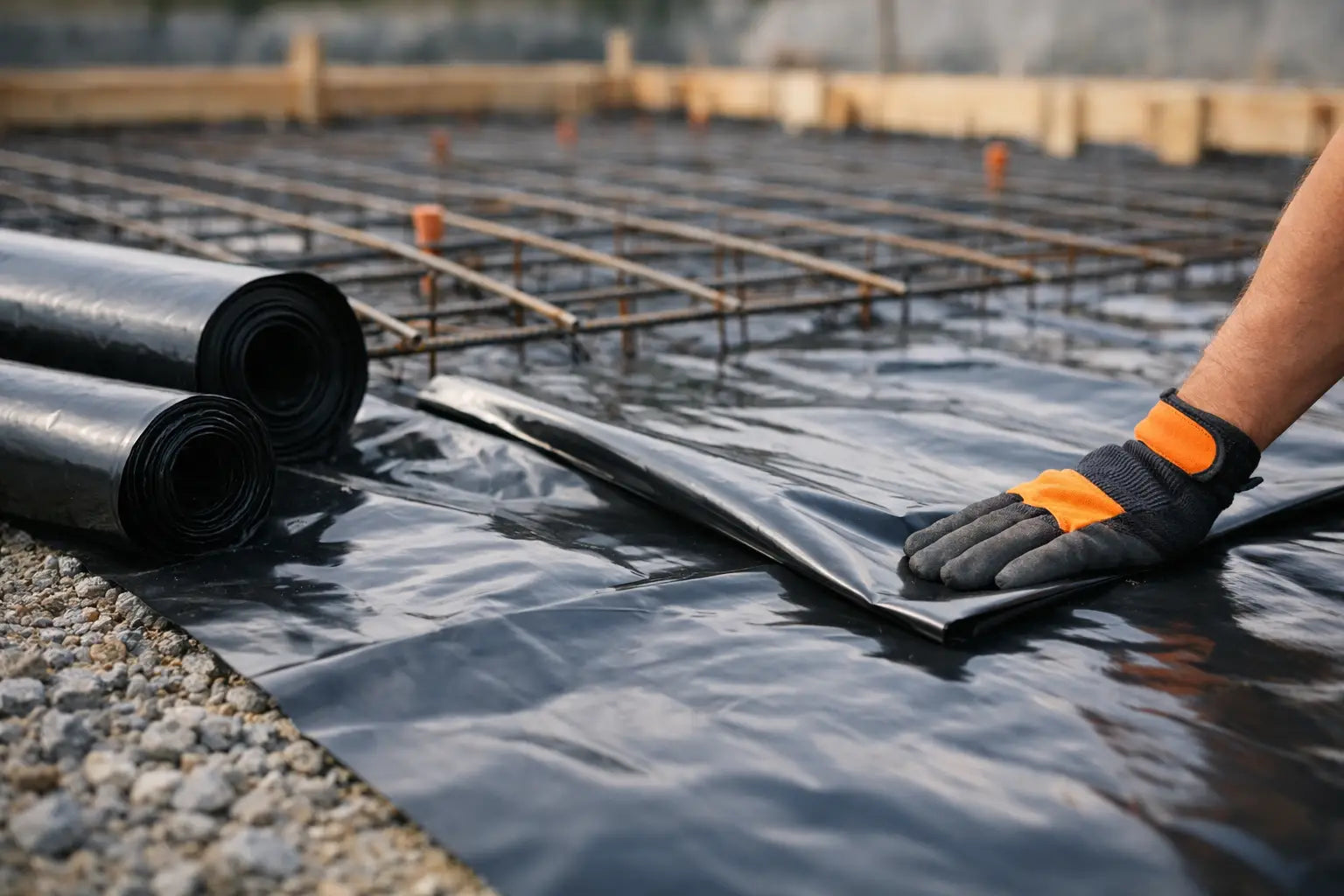

A slab can look right on pour day and still have moisture problems built into it from below. Concrete poly is the layer that separates fresh concrete from the ground, helping control moisture vapor and keeping the subgrade from pulling water out of the mix too fast. It is inexpensive compared with the cost of a failed floor system, slab repair, or delayed finish work.
For North Texas contractors, the real question is not whether to put poly under a slab. It is whether the material, thickness, coverage, and installation method match the job. A residential patio, a garage slab, a commercial building floor, and a warehouse slab can all call for different decisions. Get the poly figured out before the crew is waiting on material.
Concrete poly is polyethylene sheeting installed over prepared subgrade or a granular base before reinforcement and concrete placement. It is commonly called vapor barrier, vapor retarder, poly film, or under-slab poly. Its primary job is to limit ground moisture moving upward into the concrete and eventually into flooring, coatings, adhesives, and interior finishes.
The film also helps retain mix water during placement. When concrete sits directly on dry, absorbent soil or base material, that material can pull water from the bottom of the slab. That does not replace proper mix design, curing, or finishing practices, but it does make moisture control below the slab part of the plan instead of an afterthought.
For interior conditioned spaces, moisture protection is usually the bigger concern. Floor coverings, glue-down products, epoxy systems, and moisture-sensitive finishes can all be affected when vapor comes through the slab over time. On exterior flatwork, the requirement may be different, but poly can still be useful where plans, specifications, soil conditions, or placement methods call for it.
Not all concrete poly is the same. Thin plastic may be enough for basic temporary coverage, but it is easier to puncture during reinforcement placement and concrete work. Once the film has holes, tears, and open seams, its performance drops fast.
A 6-mil poly is common on straightforward residential work and light-duty applications when the plans allow it. It is widely available, economical, and easy for a crew to handle. The trade-off is durability. Sharp gravel, rebar chairs, boots, and dragged reinforcement can damage it quickly if the base is rough or the installation is rushed.
For more demanding slabs, many contractors move to thicker poly such as 10-mil, 15-mil, or products specifically rated for under-slab vapor protection. Thicker material costs more up front, but it holds up better around penetrations, supports, and traffic. Commercial plans and project specifications may require a particular mil thickness or a tested vapor retarder product, so do not substitute based on appearance alone.
The right choice depends on the slab use, subgrade condition, specification requirements, and how much abuse the film will take before the truck arrives. If the job has heavy reinforcement, tight bar spacing, multiple plumbing penetrations, or a rough rock base, thin film may create more repair work than it saves.
Specifications can call for more than a thickness. They may identify a required vapor transmission rating, seam overlap, tape type, placement location, or protection course. Some jobs place the vapor barrier directly below the slab. Others detail a sand or blotter layer above it. Follow the project documents and the engineer's requirements, especially on commercial work.
If plans are unclear, get the detail resolved before material is delivered. Guessing at under-slab protection is a bad way to find out the flooring contractor has a different expectation later.
Start with the slab area, then add material for overlaps, turns at edges, waste, and repair patches. Ordering only the exact square footage is how crews come up short when it is time to lap seams or wrap around grade beams.
Measure the length and width of the slab area, multiply them for square footage, then account for overlap. A practical allowance is often 10 percent to 15 percent for simple rectangular slabs. Add more for irregular foundations, interior beams, multiple penetrations, or layouts that require several sheets to be lapped and taped.
Roll width matters as much as total coverage. Wider rolls reduce the number of seams on large placements, which can save labor and reduce weak points. Smaller rolls can be easier to carry, position, and manage on residential jobs or tight access sites. There is no one roll size that wins every time. Choose the roll that lets your crew cover the area with the fewest workable seams.
Do not forget vertical coverage at perimeter conditions if the detail requires it. Poly often needs to extend up foundation walls, turn up at grade beams, or continue around penetrations. Those details consume material that will not show up in a basic slab-area calculation.
The best film will not do much if it is installed over a bad base or left open at the seams. Prep the area first. Remove sharp debris, level the base, and correct standing water or soft spots before unrolling anything. Poly laid over protruding rock is already halfway to a puncture.
Unroll the sheets flat with enough overlap to meet the project requirement. Where specifications do not state otherwise, crews commonly use generous overlaps and seal seams with compatible tape when vapor control matters. Tape is not just for appearance. It keeps sheets from separating while workers set steel, place chairs, and walk the slab.
Seal around pipe penetrations, sleeves, and other openings. These are common leak paths, especially on interior slabs that will receive finish flooring. Make clean cuts, fit the film closely, and use compatible tape or detailing materials as required. A loose hole around every plumbing penetration defeats the point of installing continuous poly.
Protect the material after it is down. Rebar supports, wire mesh, dowels, and foot traffic can all create damage. Keep a roll of tape and extra poly on site so the crew can patch tears before placement. Small repairs are normal. Ignoring them because the pour is approaching is not.
Rebar needs to stay at the elevation shown on the placement drawings, and poly should remain intact below it. That means selecting supports suited to the job and placing them carefully rather than dragging steel across the film. On heavy mats or larger commercial placements, this coordination matters even more.
If supports punch through the film or reinforcement work creates repeated tears, stop and address the setup. A few extra minutes before concrete arrives is cheaper than trying to solve moisture issues after the building is closed in.
The most common failure is using a film that is too light for the job. It looks fine when it comes off the roll, then gets torn up by the time the steel is tied. The next issue is poor seam treatment. Sheets that barely touch, overlap inconsistently, or are left untaped where sealing is required create pathways for vapor and wet concrete paste.
Another problem is treating poly as a substitute for base preparation. It is not. Concrete poly will not stabilize bad soil, fix poor drainage, replace compaction, or make up for an incorrect slab section. It is one layer in a complete slab assembly.
Finally, crews sometimes order poly late because it is viewed as a minor accessory. That can hold up the whole layout when the required thickness or roll size is not on hand. Include poly with rebar, dowels, expansion material, supports, tie wire, and tools when you build the material list. One complete order keeps the job moving better than multiple last-minute runs.
Concrete poly is basic material, but it protects work that costs a lot more than the roll itself. Specify the right thickness, order enough coverage for overlaps and details, and keep the installation tight before reinforcing steel goes down.
Rebar Concrete Products can help contractors line up poly with the rebar, supports, dowels, expansion material, and other concrete jobsite materials needed for the pour. Bring in the slab dimensions and project requirements early, and get the material plan handled before pour day turns into a supply problem.
